The Center City Commuter Connection
Key Insights
- • The Infrastructure: A 1.7-mile, $330 million tunnel united the Pennsylvania and Reading railroad networks in 1984.
- • The Impact: Eliminated downtown transfers, saving 2,500 daily person-hours and enabling direct suburb-to-suburb travel.
- • The Unmet Potential: Despite physical capacity rivaling Munich's S-Bahn, funding crises and operational choices have prevented true high-frequency metro service.
Beneath Philadelphia's streets runs a 1.7-mile tunnel completed in 1984 at a cost of $330 million. The Center City Commuter Connection links the former Pennsylvania Railroad network, which terminated at Suburban Station, with the former Reading Company network, which ended at Reading Terminal four blocks away. Before the tunnel, passengers traveling between the two systems had to walk through downtown streets or navigate underground passages.
Vision Amidst Decline
When R. Damon Childs, a junior planner at the Philadelphia City Planning Commission, was tasked with developing mass transit concepts for the city's comprehensive plan in 1958, he focused on a declining area. Market East, the area between the two terminals, was losing population and businesses. Department stores along East Market Street struggled to attract customers from Philadelphia's western suburbs who arrived at Suburban Station but faced a lengthy walk or transfer to reach the shopping district.
Though city planning director Edmund Bacon initially doubted the tunnel concept, he incorporated it into the 1960 Comprehensive Plan after Childs demonstrated its viability and potential impact. The proposal called for connecting the two commuter railroads with a subway under Filbert Street, eliminating Reading Terminal and making Suburban Station primarily a through-station rather than a terminus.
The concept remained dormant for over a decade. In 1964, Philadelphia submitted the first funding application received by the newly formed Urban Mass Transportation Administration. UMTA initially rejected the proposal, viewing it as urban renewal rather than transportation improvement. By 1970, federal officials concluded that "the benefits to the Philadelphia area mass transportation system resulting from the center city project are, at best, minimal."
Politics and Federal Funding
After Frank Rizzo became mayor in 1972, he made the tunnel his administration's top transportation priority. His staff convinced him the project could become his legacy to the city. To focus resources on securing federal funding for the tunnel, Rizzo delayed other major transit projects, including replacement of aging Broad Street Subway cars dating to 1928.
Federal Transportation Secretary William Coleman approved funding in January 1977 after initially opposing the project. Coleman believed the tunnel would create substantial employment opportunities for African Americans in Philadelphia's construction industry. The federal government committed to funding 80 percent of the project's cost, approximately $240 million.
Engineering Feats

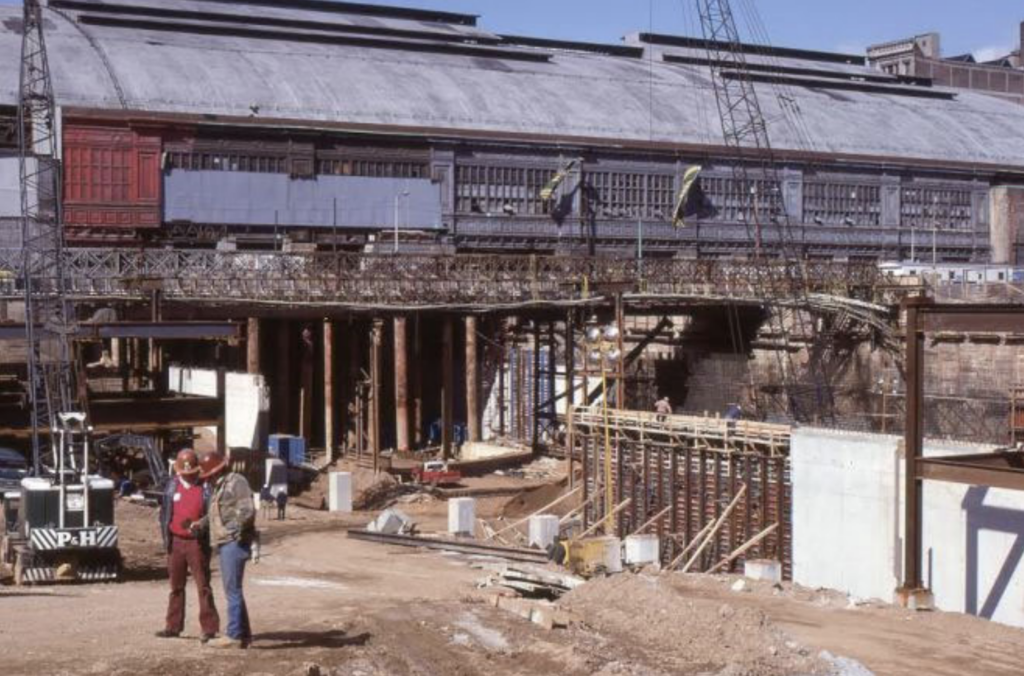

Construction began on June 22, 1978. The tunnel route extended eastward from Suburban Station, passing above the north-south Broad Street Subway near City Hall. Engineers had to demolish and rebuild a 120-foot section of the subway roof while maintaining service on at least two of four tracks. The tunnel curved north through Chinatown, descended to its lowest point 20 feet below sea level at the rebuilt Chinatown Station, then gradually ascended to connect with the elevated Reading tracks.
Where the tunnel passed beneath City Hall, engineering challenges multiplied. The tunnel passed directly under the 14-story City Hall Annex, requiring needle beam underpinning to support the building's columns along Filbert Street. When cracks appeared in the ornate interior plaster of the 19th-century Masonic Temple, engineers developed stronger underpinning methods using grout injection stabilization. Twelve buildings along the route required underpinning with concrete-filled, hand-dug piers.
Construction disrupted Chinatown businesses with noise, dust, parking problems, and altered traffic patterns. The city's project engineers worked directly with residents and business owners to address ongoing concerns. The Chinatown Station of the Ridge Avenue Subway had to be demolished and rebuilt on top of the new commuter tunnel. As part of community negotiations, the city commissioned the Chinatown Friendship Arch, crafted by artisans from China.
The project did not deliver on its employment promises. By 1979, contracts awarded to Black-owned businesses constituted a minimal percentage of the project's total cost. The Philadelphia Tribune reported in 1981 that the tunnel had produced 1,000 total jobs, ten percent of projections.
Critics questioned whether the tunnel's 2.8 percent grade was too steep for existing equipment. The older Reading Blueliner electric multiple units successfully handled the incline when service began, dispelling these concerns.
Operational Success and Revitalization
The tunnel opened for full service on November 10, 1984, after a Market East-Suburban Station shuttle had operated since June. One week later, engineers discovered the four-track Columbia Avenue bridge on the former Reading line was in imminent danger of collapse, forcing extended service cuts that lasted months.
By eliminating the transfer process that previously required passengers to take a seven-minute subway connection downtown, wait for the next train, then ride twelve minutes to reach the other rail network, through-running saved approximately 2,500 person-hours daily across the system. The tunnel's 3-4 minute journey replaced this entire sequence. Planners projected the tunnel would generate between 13,000 and 18,000 additional weekday rail trips while eliminating approximately 10,800 daily automobile trips to Center City.
The operational improvements were immediate. The number of trains needed to maintain equivalent service levels dropped by more than half on combined routes. Crew hours decreased by 22 percent. Train-miles fell 5.5 percent while maintaining identical service coverage. The system no longer required empty "deadhead" trips to reposition trains between terminals.
Market East Station became the catalyst for area revitalization. The Reading Terminal Market, previously in decline, attracted new visitors and businesses. The Pennsylvania Convention Center opened nearby in 1993, generating additional development around the transit corridor. Real estate values rose, producing more than $20 million in additional annual tax revenue for the city.
Unrealized Potential
The tunnel enabled suburb-to-suburb travel without downtown transfers. A passenger could board a train in Trenton on the former Pennsylvania network and travel directly to Wyndmoor Station on the former Reading network. This connectivity supported reverse-commute patterns as suburban job centers became accessible to city residents without multiple transfers.

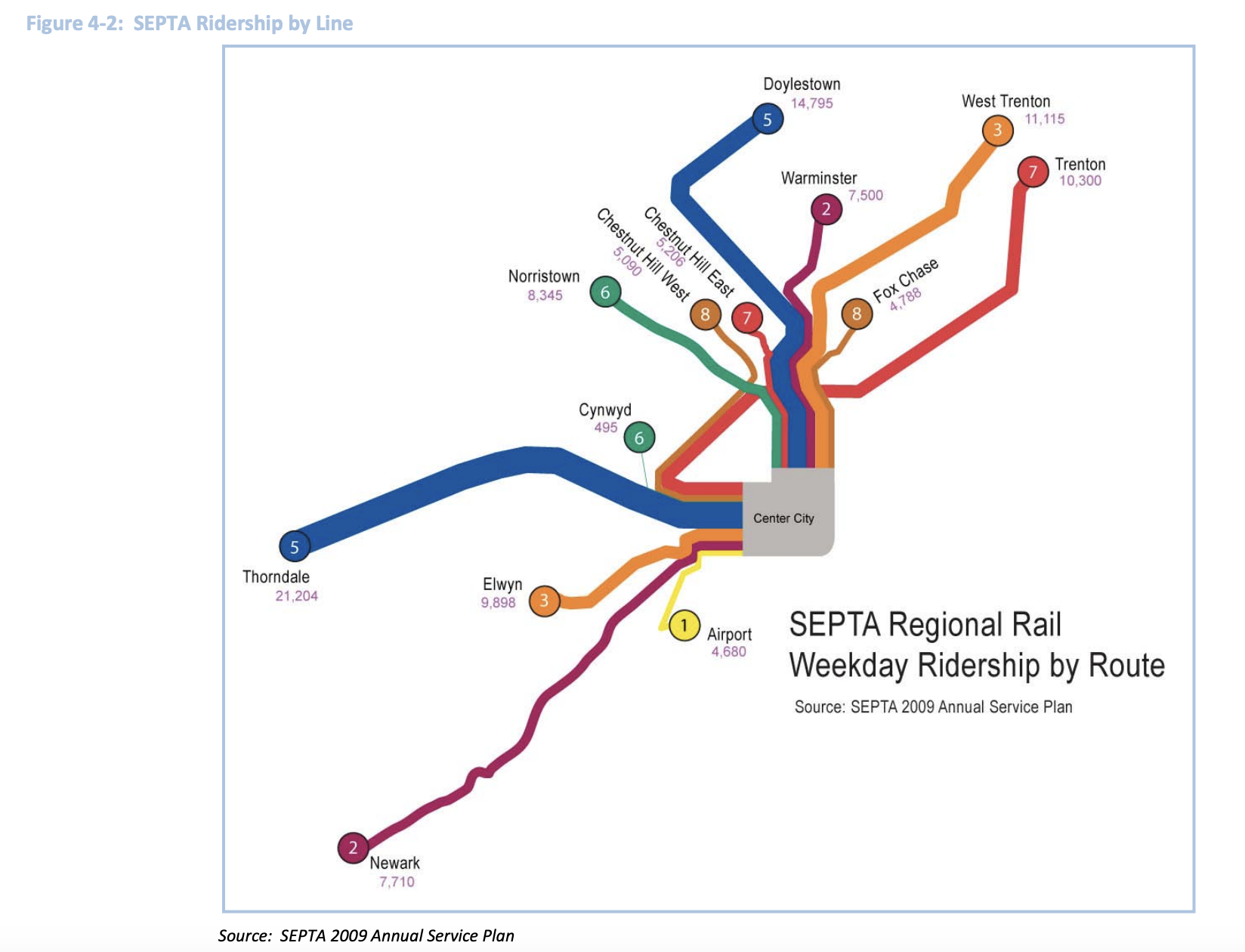

Today, only five percent of passengers utilize the through-routing capabilities. SEPTA's current operations contradict the original design. R2 trains become R6 trains when passing through downtown from the south and R1 trains when coming from the north. R6 trains from Cynwyd terminate at Suburban Station despite the line nominally continuing to Norristown. Weekend R7 trains from Chestnut Hill East become R3s headed to Elwyn. Many trains terminate downtown rather than continuing through the tunnel.
While Munich's S-Bahn operates with peak frequencies of one train every two minutes through its central tunnel by running individual lines every ten minutes and interlining multiple routes, Philadelphia's four-track tunnel operates far below this threshold despite having greater physical capacity than Munich's two-track system. The Center City Commuter Connection demonstrated that American cities could build European-style through-running rail systems and Philadelphia created the infrastructure for a unified regional network.
Whether that potential finally gets realized depends not on the tunnel itself, but on the operational choices made above it. Given the recent SEPTA funding crisis, the chance of seeing service frequencies increase is slim. With the agency forced to transfer nearly $400 million in capital funds to cover operations just to avoid service cuts in 2026, the modernization needed to run a high-frequency, European-style metro system remains financially out of reach.
